Construction Update: Westgate, Park Row, Oxford Place

As part of Leeds City Council’s on-going commitment to meet their green energy targets, further extensions to the Leeds PIPES heat network are planned to take place early in the New Year, from 8th January 2024.

The works will involve some lane closures on Westgate & Park Lane, both inbound and outbound, followed by closure of Oxford Place on 19th February 2024 for 3 weeks. These works will take place from 7:30am – 5pm, Monday – Saturday, with the possibility of an occasional evening or weekend. Traffic management arrangements will need to be in place for 24 hour durations.

We will strive to keep any disruption and noise to a minimum during these works.

Please see images below of the plans for the phased scheme of works (click the image to enlarge).

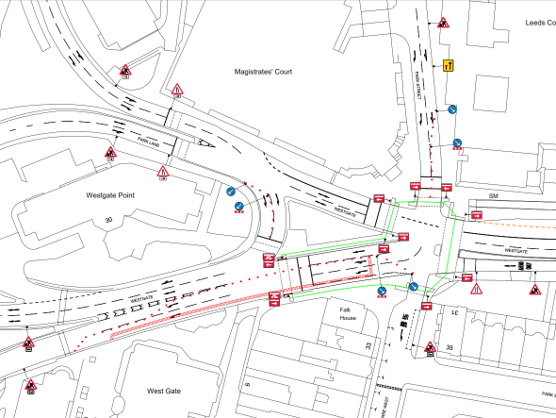

Phase 1 – Westgate Eastbound

8th Jan to 24th Jan

Phase 2 – Westgate Crossing

24th Jan to 30th Jan

Phase 3 – Westgate Westbound

31st Jan to 8th Feb

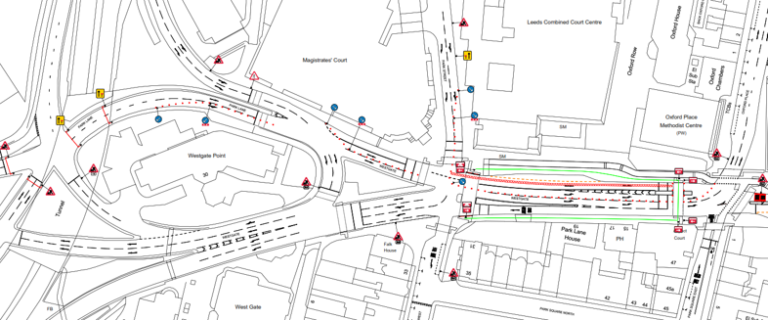

Phase 4 – Bus Lane Route

9th Feb to 28th Feb

Phase 5 – Oxford Place – Final Connection

19th Feb to 8th March
